Engineering Permit Application Status
SPRSW231783
In order to view fees, you need to be signed in. You will only be able to schedule inspections if you are a contact on the permit application.
Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.
Review Type | Outcome | Est. Completion Date | Completed |
---|---|---|---|
Construction Stormwater Review | Approved | 01/10/2024 | 03/25/2024 |
Scott Slamal
|
|||
Inspection | Outcome | Requested | Scheduled | Date Inspected |
---|---|---|---|---|
Interim Construction Stormwater | Pending | |||
Scott Slamal | ||||
Final Construction Stormwater | Pending | |||
Scott Slamal | ||||
45 Day Inspection | Pending | 8/9/2025 | ||
Scott Slamal | ||||
Corrections:
Miscellaneous
Outstanding
06/25/2025

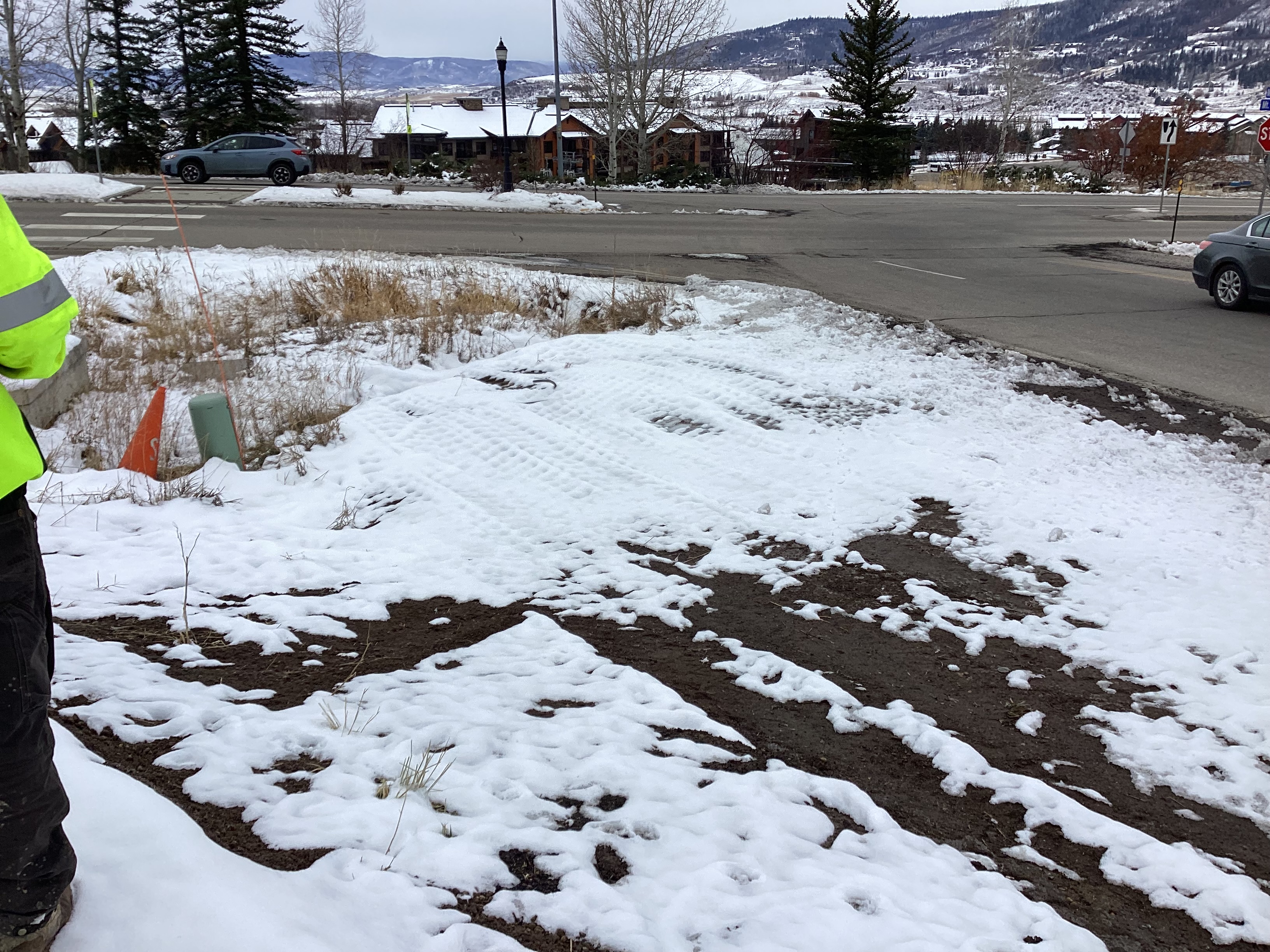

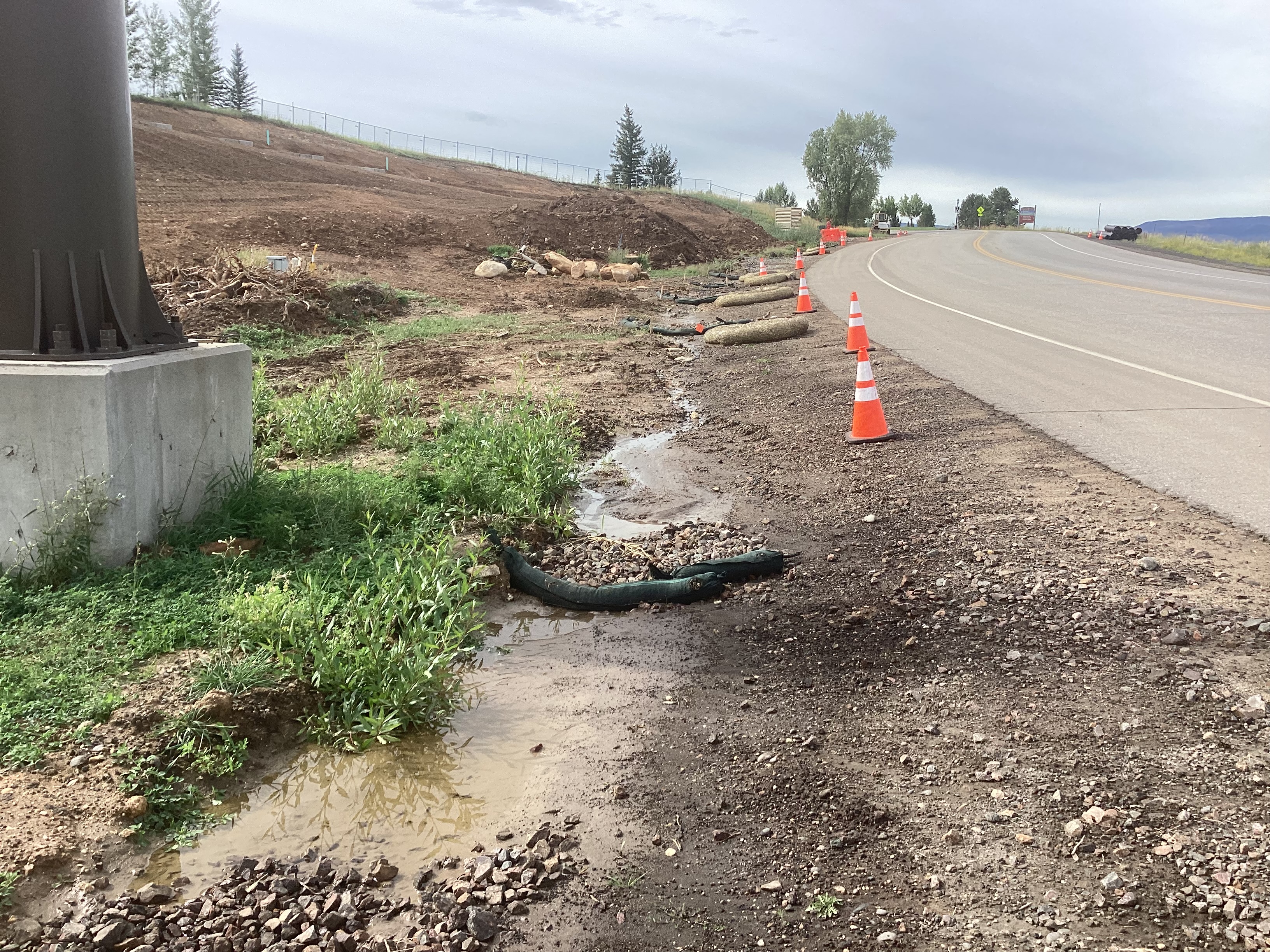

Pick up trash as needed throughout the site.
|
||||
Miscellaneous
Outstanding
06/25/2025

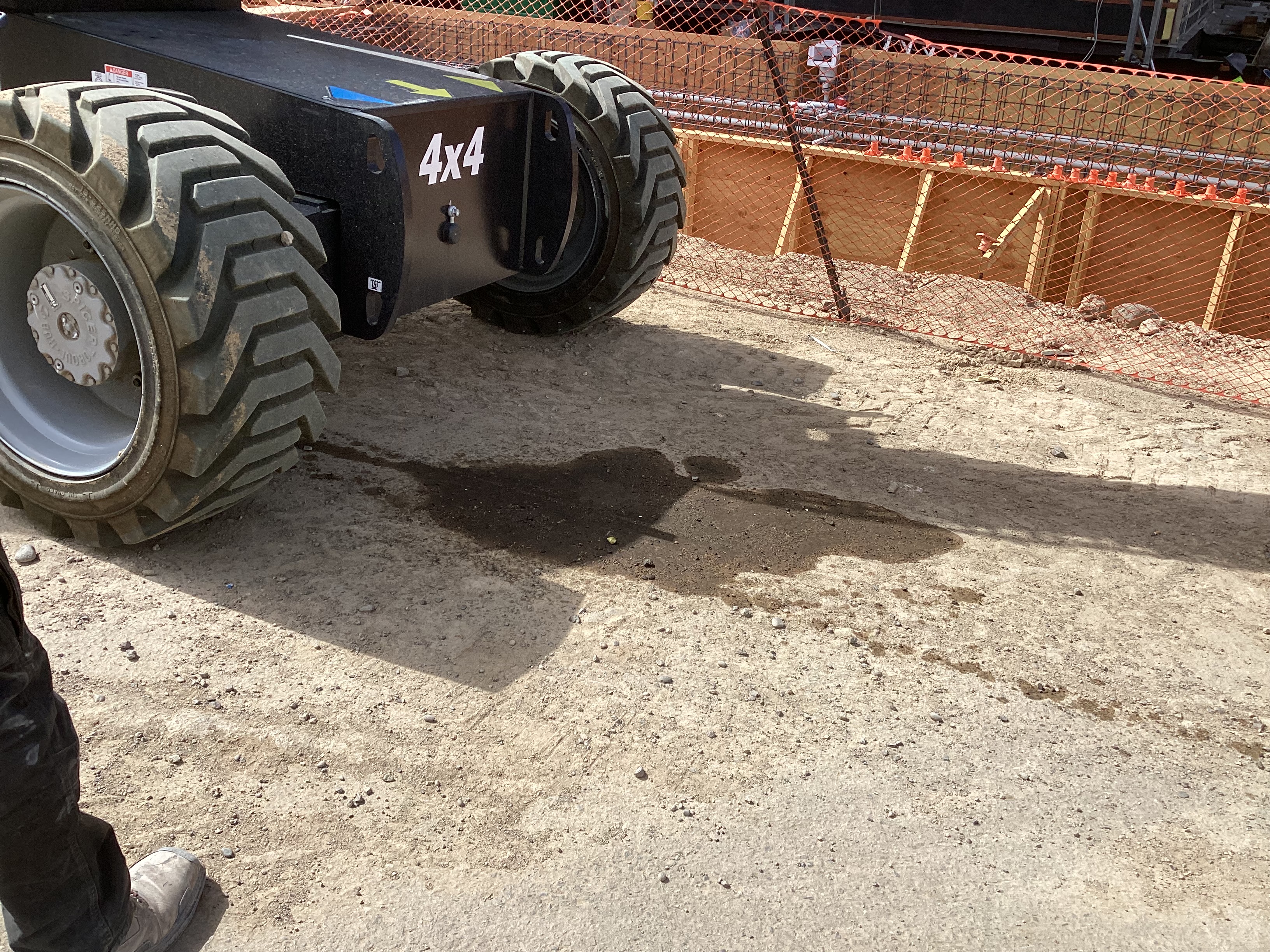

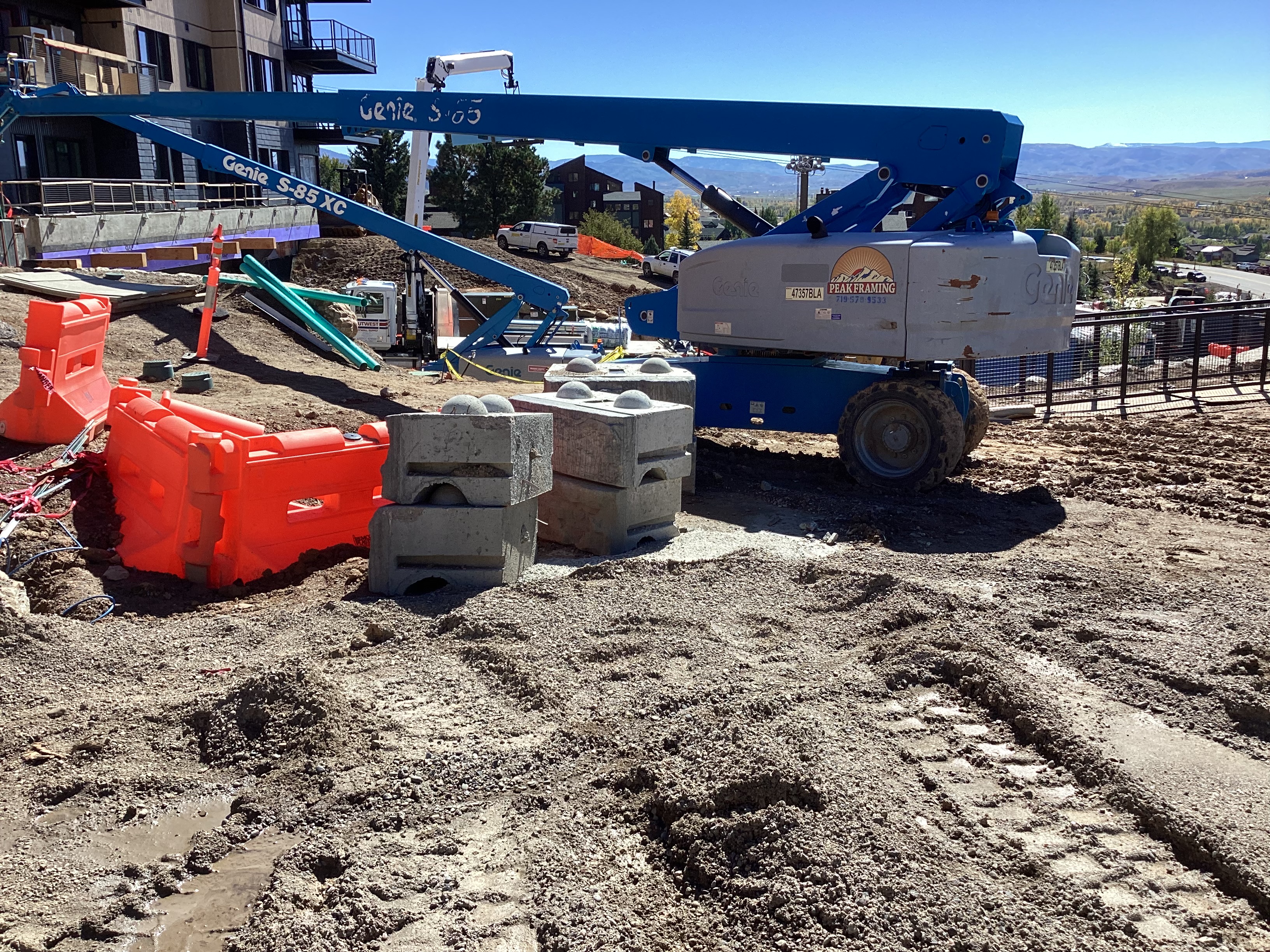

Clean up leaked hydraulic fluid and have boom lift repaired/maintained.
|
||||
45 Day Inspection | Passed | 5/28/2024 | 05/28/2024 | |
Scott Slamal | ||||
45 Day Inspection | Passed | 7/12/2024 | 07/12/2024 | |
Scott Slamal | ||||
45 Day Inspection | Passed | 8/21/2024 | 08/26/2024 | |
Scott Slamal | ||||
45 Day Inspection | Failed | 11/22/2024 | 09/25/2024 | |
Scott Slamal | ||||
45 Day Inspection | Passed | 11/4/2024 | 11/04/2024 | |
Scott Slamal | ||||
45 Day Inspection | Failed | 3/28/2025 | 03/28/2025 | |
Scott Slamal | ||||
Corrections:
Miscellaneous
Carried Forward
03/31/2025

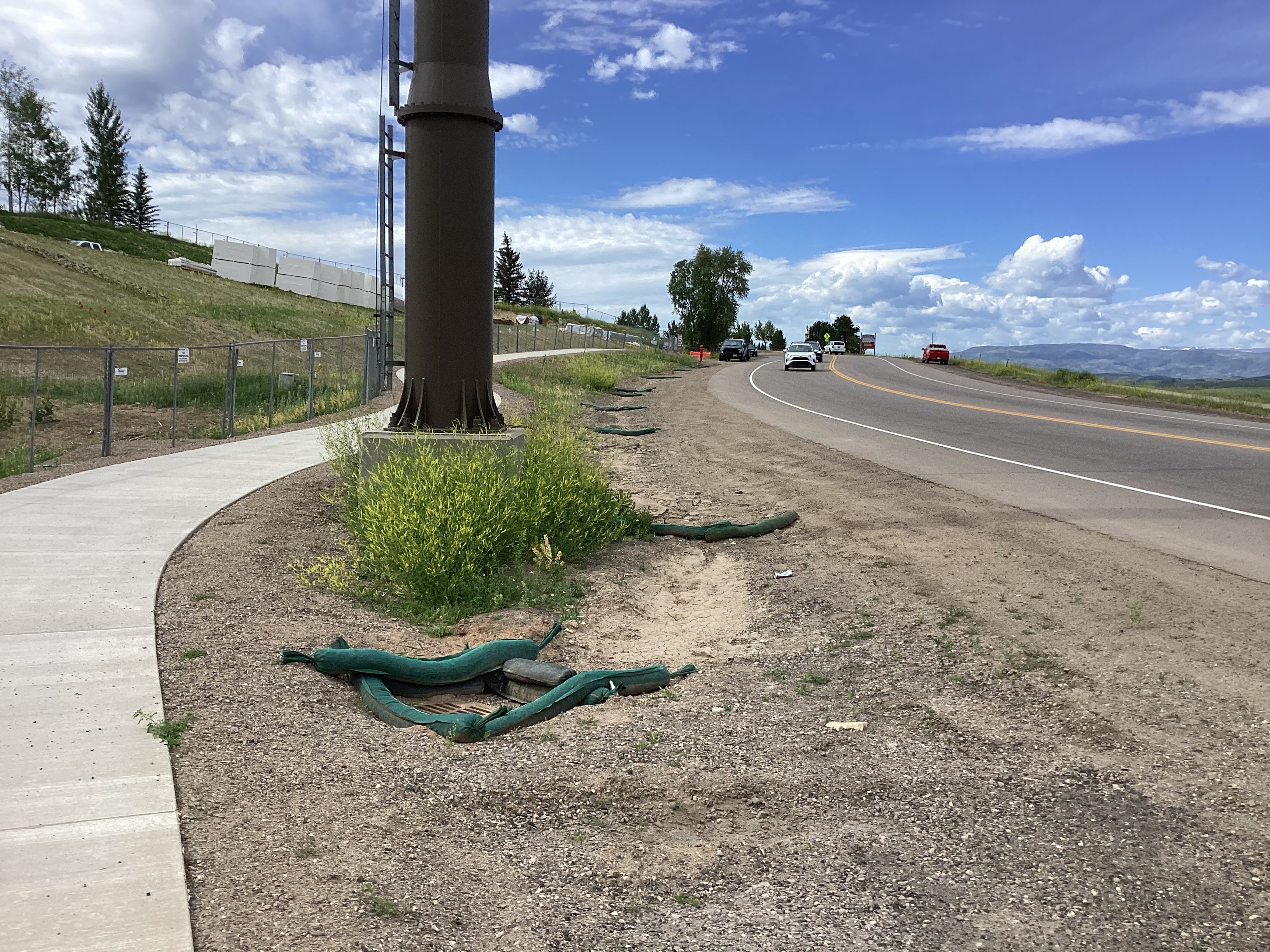

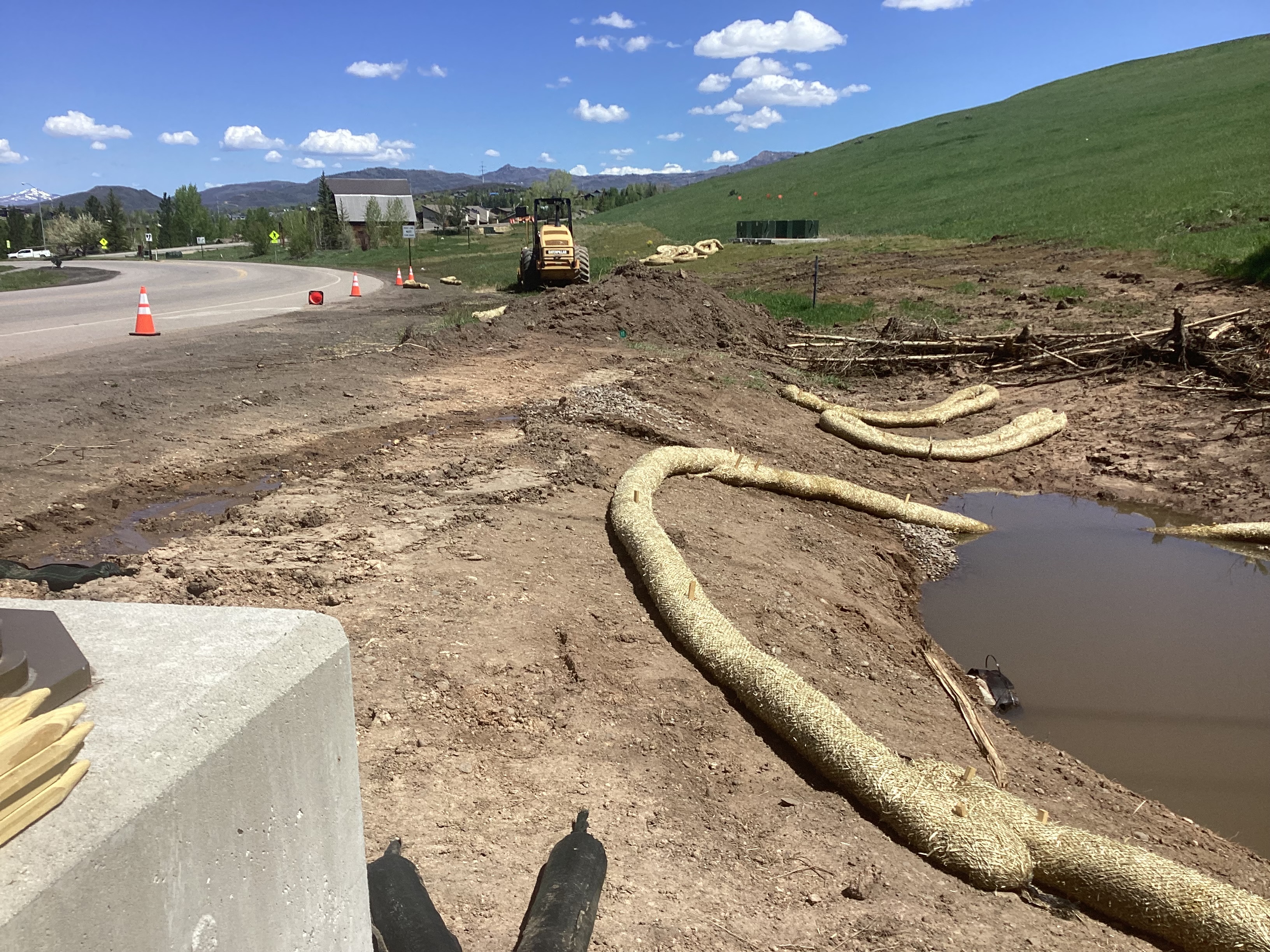

Maintain rock lined ditch from sediment basin to redirect runoff into ditch.
|
||||
Miscellaneous
Carried Forward
03/31/2025
Final grade section of road cut from retaining wall to entrance and install erosion control blankets. Per Engineering Standards, 8.7.5 TEMPORARY SOIL STABILIZATION, Temporary soil stabilization is required on all portions of the site where grading and land disturbing activities are complete and on any portion of the site that is inactive for at least 14 days.
|
||||
Miscellaneous
Carried Forward
03/31/2025
Pick up trash on south side of building structure and through out construction zones as needed.
|
||||
Miscellaneous
Carried Forward
03/31/2025

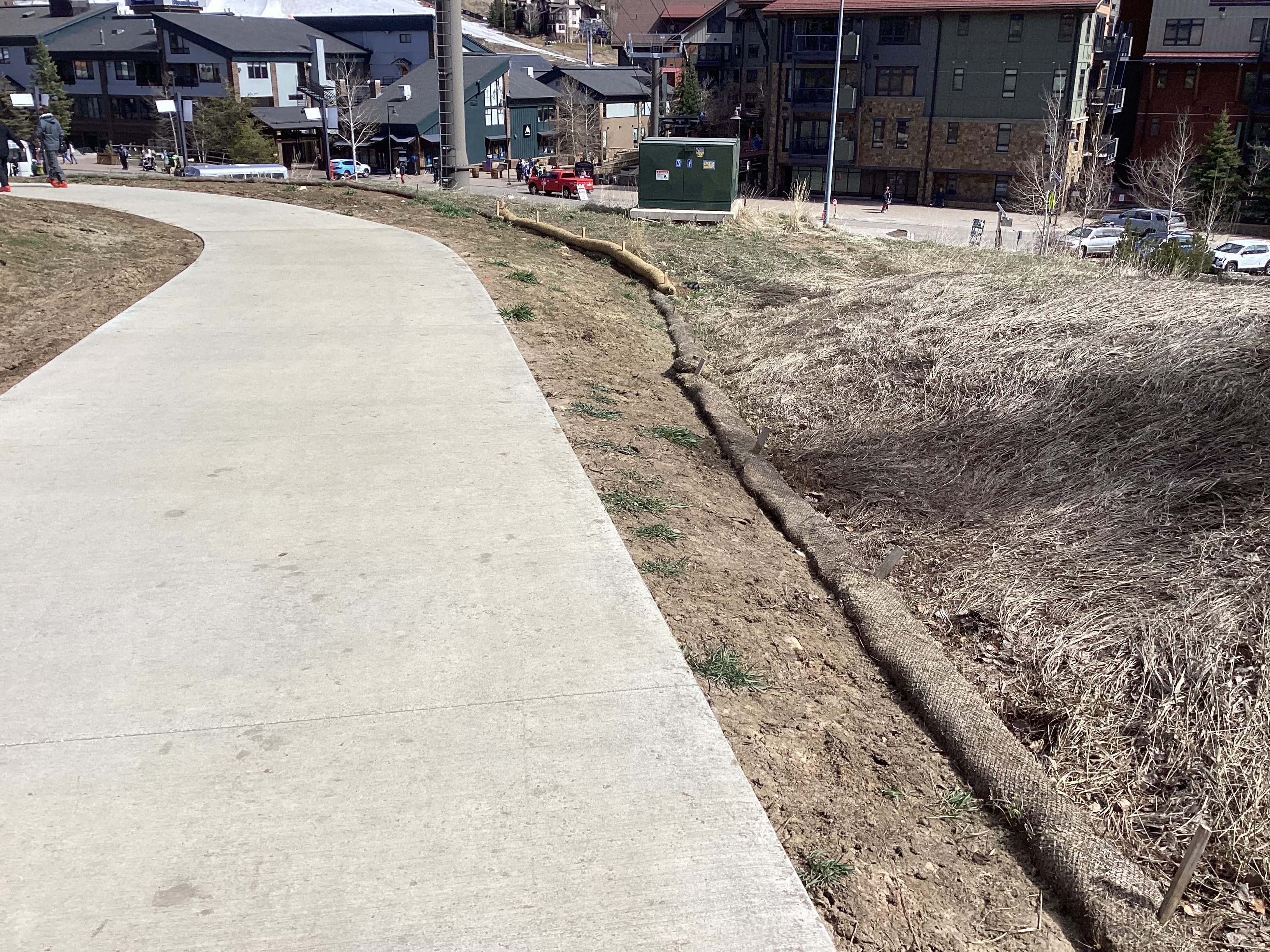

Reinstall erosion control blankets as needed on road cut along corner of access road.
|
||||
Miscellaneous
Carried Forward
03/31/2025

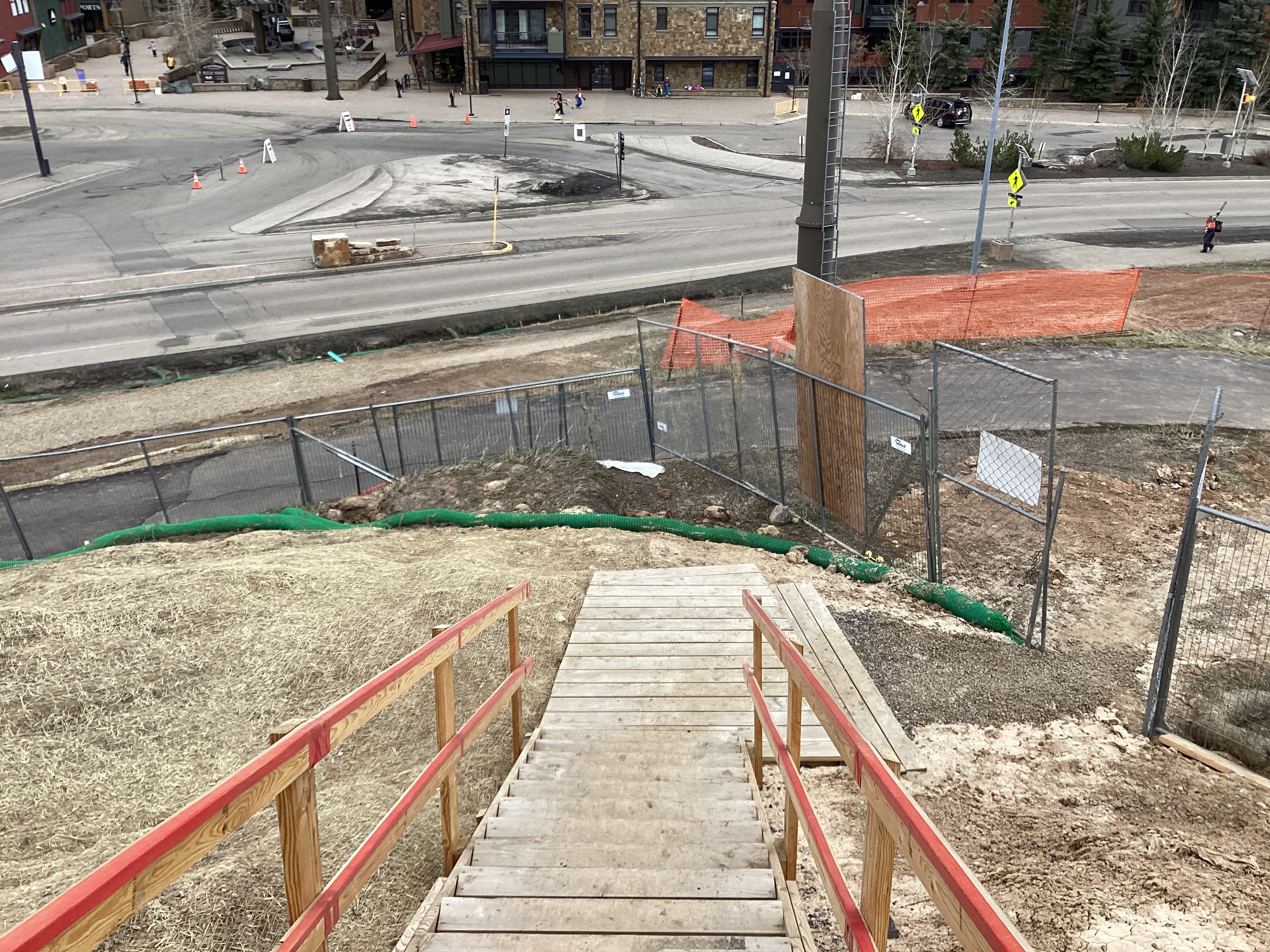

Install road barriers along corner of access road and install sediment controls.
|
||||
45 Day Inspection | Failed | 6/21/2025 | 05/07/2025 | |
Scott Slamal | ||||
Corrections:
Miscellaneous
Resolved
05/07/2025
Maintain rock lined ditch from sediment basin to redirect runoff into ditch.
|
||||
Miscellaneous
Resolved
05/07/2025
Final grade section of road cut from retaining wall to entrance and install erosion control blankets. Per Engineering Standards, 8.7.5 TEMPORARY SOIL STABILIZATION, Temporary soil stabilization is required on all portions of the site where grading and land disturbing activities are complete and on any portion of the site that is inactive for at least 14 days.
|
||||
Miscellaneous
Carried Forward
05/07/2025
Pick up trash on south side of the building as needed.
|
||||
Miscellaneous
Resolved
05/07/2025
Reinstall erosion control blankets as needed on road cut along corner of access road.
|
||||
Miscellaneous
Resolved
05/07/2025
Install road barriers along corner of access road and install sediment controls.
|
||||
45 Day Inspection | Failed | 8/9/2025 | 06/25/2025 | |
Scott Slamal | ||||
Corrections:
Miscellaneous
Carried Forward
06/25/2025
Pick up trash as needed throughout the site.
|
||||
Miscellaneous
Carried Forward
06/25/2025
Clean up leaked hydraulic fluid and have boom lift repaired/maintained.
|
There are no conditions for this engineering permit application, or you are not authorized to view them.
There are no related items for this engineering permit application.
